Willow Springs Water Bank Conjunctive Use Project
Applicant | Southern California Water Bank Authority |
---|---|
Status | MCED Issued |
Project Type | Conjunctive Use |
Public Benefits | Ecosystem Improvements, Emergency Response |
Total Project Cost | $343,000,000 |
Maximum Conditional Eligibility Determination (MCED) | $128,274,876 |
Early Funding | $6,413,744 |

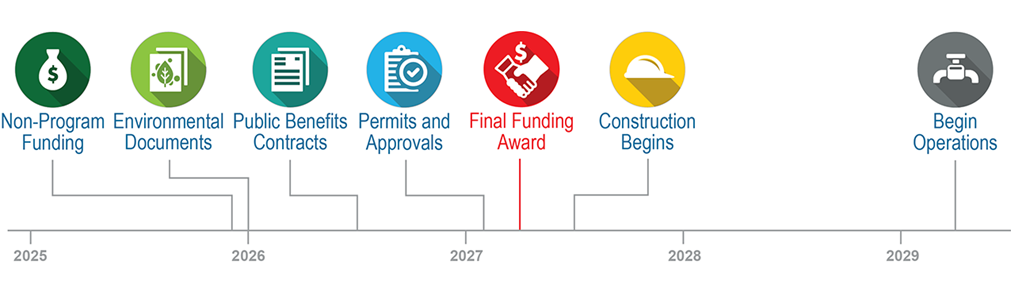

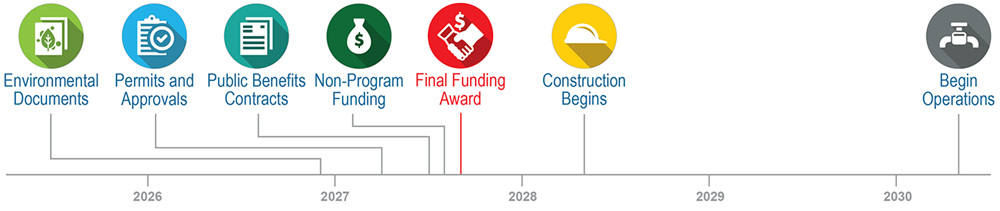

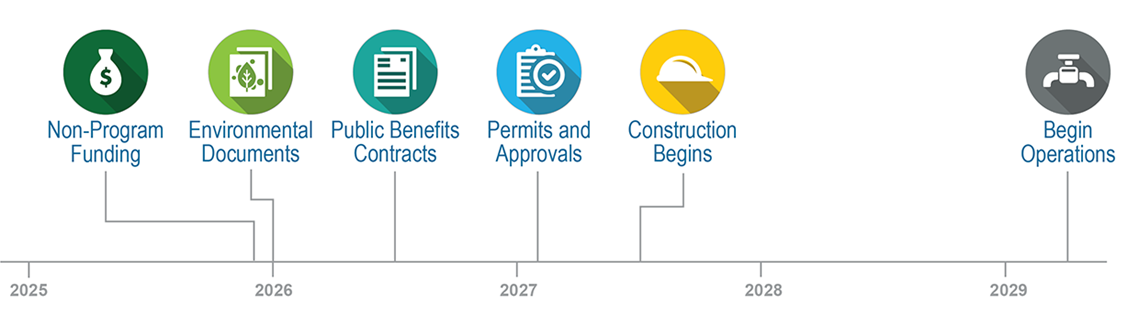

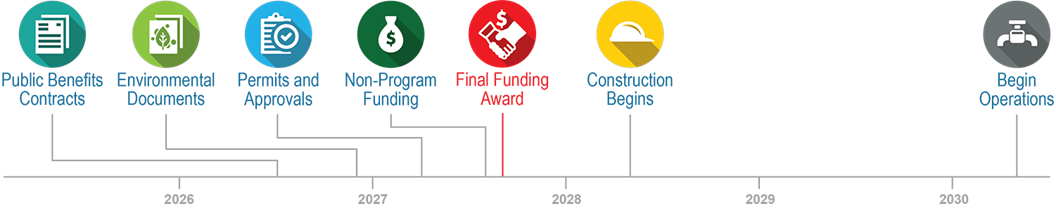

Projected Timeline
Environmental Documentation: An Environmental Impact Report (EIR) was completed in 2016. The Pulse Flow EIR, certified by the Department of Water Resources (DWR), needs to be adopted by the project. Additional environmental documentation for conveyance is expected to be completed by the end of 2025
Permits and Approvals: An exchange agreement for pulse flows is expected by early 2027. It is unknown if additional agreements are needed until the final pipeline alignment is determined.
Public Benefit Contracts: Contracts with the California Department of Fish and Wildlife for pulse flows on the Feather River, and DWR for emergency response benefits are expected to be completed in mid-2026.
Non-Program Funding: An agreement with the Antelope Valley-East Kern Water Agency (AVEK) is expected to be completed in November 2025.
* Completion dates are Commission staff’s best estimates based on applicants’ quarterly reports and other public information as of July 30, 2025.

Project-Related Documents
Supporting Documents:
- Draft Environmental Impact Report (EIR) Antelope Valley Water Bank Project: Specific Plan Amendment No. 13, Map 232, Specific Plan Amendment No. 2, Map 233, Alteration of Boundaries of Agricultural Preserve No. 24 - Inclusion
- Addendum to the EIR for Willow Springs Water Bank Project (formerly Antelope Valley Water Bank Project)
- Letter of Commitment for 75% Non-public Benefit Cost Share
- Feasibility Study: Willow Springs Water Bank Conjunctive Use Project (available upon request)
